A replacement window can fit the opening and still change the character of a listed house. Before choosing products, establish what can be repaired, which details should be retained and what needs permission. Those decisions should shape the specification, rather than follow the order confirmation.

Establish what needs permission
In England, listed building consent is required for demolition and for alterations or extensions that would affect a building’s character as a building of special architectural or historic interest. Planning permission and building regulations are separate considerations. Elsewhere in the UK, check the relevant national guidance and local authority requirements.
Read the list entry as a starting point, rather than a complete inventory of protected features. Interiors can also be protected. Ask the local planning authority about the proposed work: genuinely matching repairs may not need consent, but the description ‘repair’ alone is insufficient to establish that.

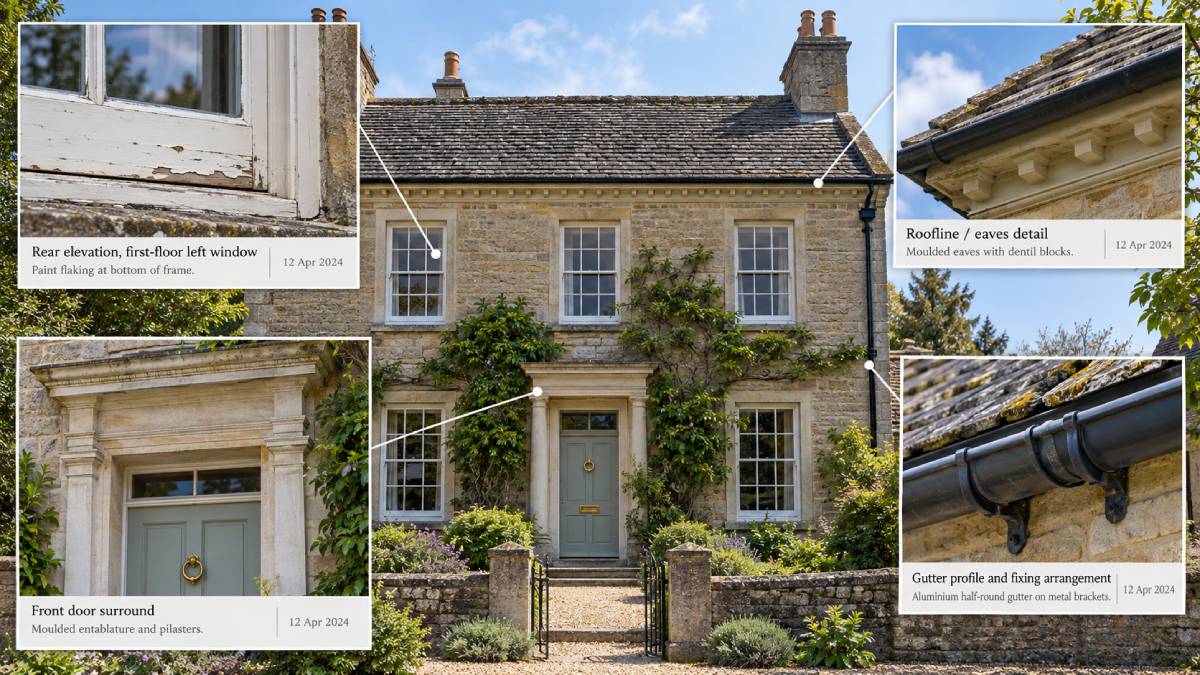

Record existing features in useful detail

Photograph windows, doors and roofline details, noting their locations and the date. For rainwater goods, record the existing material, profile, dimensions and fixing arrangement.
Once an aluminium replacement has been agreed as appropriate and any required consent obtained, an aluminum gutter supplier can confirm available dimensions, profiles and finishes against the specification.
Include an overall photograph alongside close-ups, so each detail can be seen in relation to neighbouring features. Labels such as ‘rear elevation, first-floor left window’ help advisers and contractors identify the same item.
Keep observations separate from proposed solutions. ‘Paint flaking at the bottom of the frame’ records a visible condition; ‘replace frame’ is a decision requiring assessment. Leave measurements involving unsafe access to competent professionals.

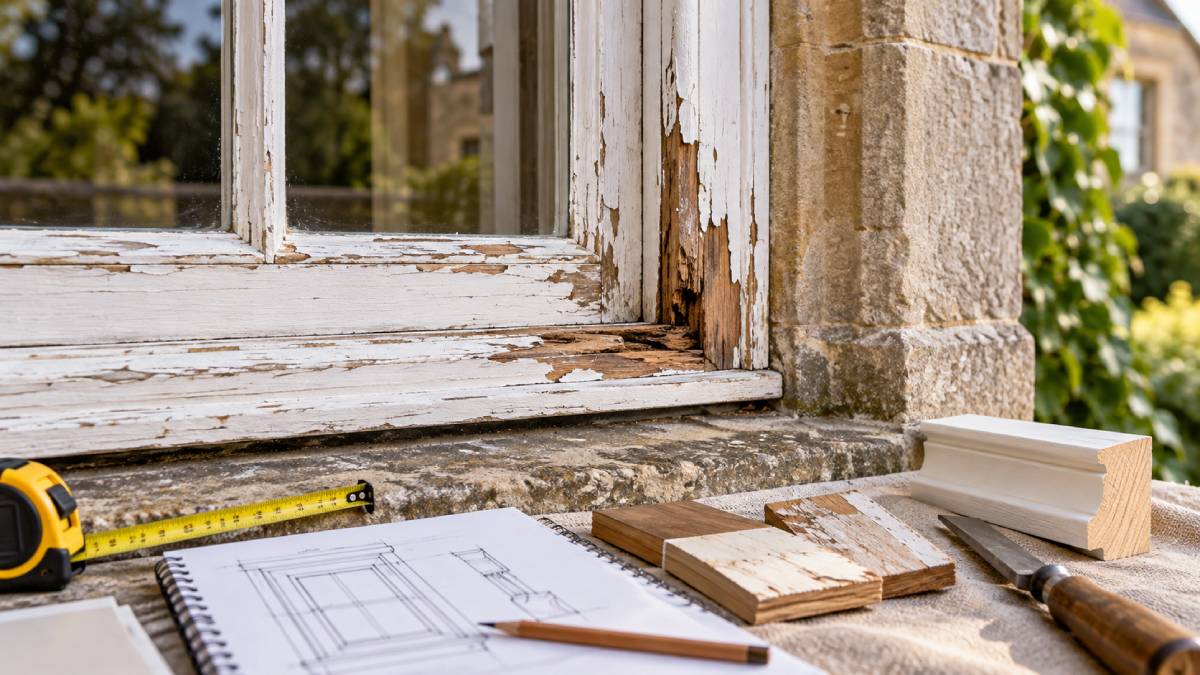

Assess repair before replacement

A surveyor, architect or suitably experienced craftsperson should assess the affected features. Look for relevant historic-building experience, rather than a general promise to work sympathetically.
For a damaged window, establish how much sound material remains, whether deterioration is localised and what a repair would involve. Assess the material beneath a worn finish before deciding on replacement. Where replacement is proposed, record why repair is unsuitable and which existing details the new work should retain.
Separate essential repairs from optional improvements. Protecting the structure and keeping out weather should take priority over decorative changes. Discuss the sequence with your adviser, including whether later work would disturb newly repaired surfaces.

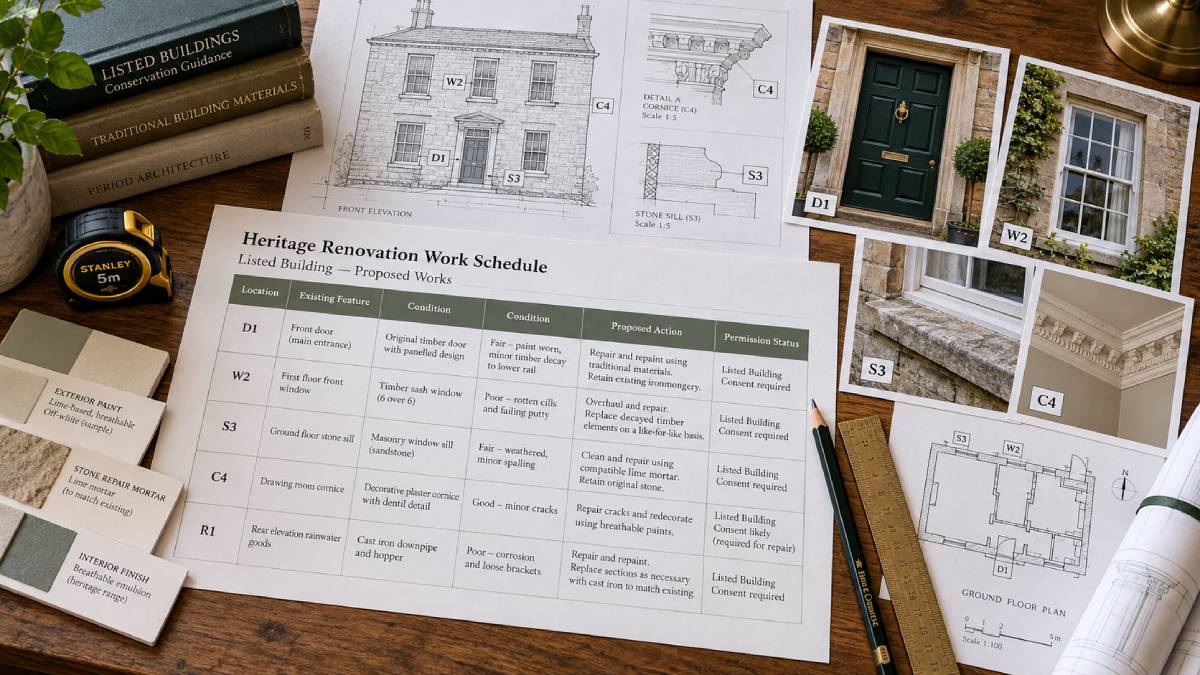

Turn proposals into a clear work schedule

Create a schedule with five fields: location, existing feature, condition, proposed action and permission status. Give each item a reference that also appears on photographs and drawings.
‘Renovate front door’ leaves too much open to interpretation. A useful entry identifies whether the door leaf is retained, which frame sections need repair, the intended finish and how adjacent surfaces will be protected. Mark outstanding decisions explicitly so everyone can see where further advice is needed.
Ask the planning authority what supporting information it requires. Depending on the proposal, this may include drawings, photographs and an explanation of the feature’s significance and the reasons for intervention.
Use the same schedule when obtaining quotations. Ask contractors to state their assumptions and exclusions, covering access equipment, protection of retained features and making good afterwards. Agree who checks specifications and who authorises changes before work starts.

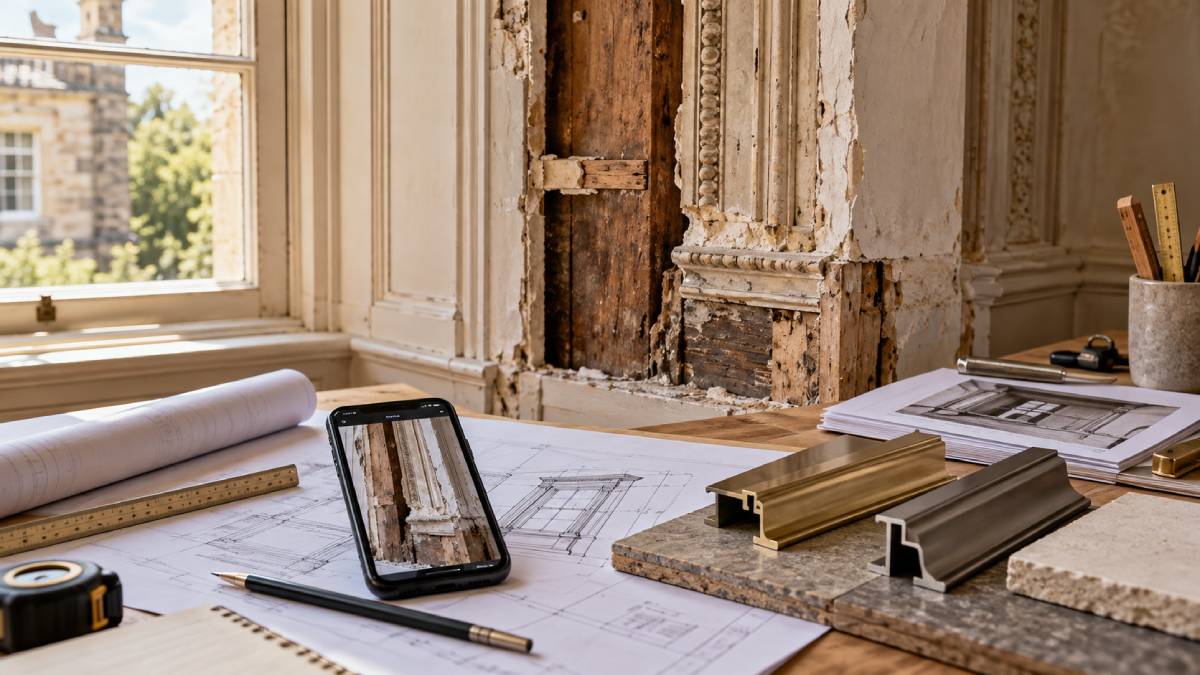

Plan for discoveries and substitutions

Opening up part of an old building can reveal features or construction hidden during the initial assessment. Decide beforehand who the contractor should contact if this happens.
Pause the affected work, photograph the discovery and have the relevant adviser assess it before further material is removed. Establish whether the response changes the agreed scope or requires additional approval before continuing.
Apply the same review process to product substitutions. If a specified component is unavailable, request the alternative’s details. Even a small difference in dimensions, finish or installation method can alter the result.
Check the details before placing orders
Before committing to replacement materials, confirm that:
- Repair options have been assessed and the replacement scope is clear.
- Required approvals are in place, with relevant pre-start conditions addressed.
- Dimensions and specifications have been checked.
- Responsibility for reviewing changes has been agreed.
Resolve the specification before fixing delivery and installation dates.
Keep approvals, drawings, specifications and completion photographs together, with a short record of what was retained, repaired or replaced. The next person maintaining the house will then have a clear account of the work and the decisions behind it.
